High-grade gold and silver results continue substantially beyond Resource Pits at Tahonitas with drilling intercepting 6.30 gpt AuEq over 6.3 m etw

VANCOUVER, British Columbia, Nov. 08, 2023 (GLOBE NEWSWIRE) — Prime Mining Corp. (“Prime” or the “Company”) (TSX-V: PRYM, OTCQX: PRMNF, Frankfurt: 04V3) is reporting expansion drilling results from the Company’s Los Reyes Project (the “Project”), located in Sinaloa State, Mexico. These results come from the Z-T Area and are not included in the Company’s May 2, 2023 Mineral Resource Estimate (“MRE”).

Prime Mining Corp. Chief Executive Officer Daniel Kunz commented, “The drill results released today continue to extend the high-grade plunge at the south-east end of the Z-T Area, known as Tahonitas. Today’s results, along with previously released holes in this area, have extended mineralization approximately 250m down-dip from the May 2023 resource pits. We are excited by how the mineralization in this area is developing and continue to drill Z-T as part of our success-based drill program.”

Scott Smith, Executive Vice President of Exploration, added, “The exploration team is working diligently to execute on our strategic drilling plan with six drills currently operating. Today’s release reflects a portion of the Tahonitas drilling in-progress, as we continue to process and receive drilling results from Z-T in addition to other expansion and generative areas.”

Expansion Drilling Highlights in the Z-T Area:

Tahonitas
The Company is reporting nine core holes in the Tahonitas area that include the following highlights:

  • 2.49 grams per tonne (“gpt”) gold-equivalent (“AuEq”) (2.11 gpt Au and 29.3 gpt Ag) over 20.1 metres (“m”) estimated true width (“etw”) in hole 23TA-79, including:
    • 6.30 gpt AuEq (5.74 gpt Au and 42.9 gpt Ag) over 6.3 m etw.
  • 2.00 gpt AuEq (1.06 gpt Au and 72.6 gpt Ag) over 5.5 m etw in hole 23TA-80, including:
    • 3.59 gpt AuEq (2.57 gpt Au and 78.5 gpt Ag) over 1.8 m etw.
  • 1.14 gpt AuEq (1.04 gpt Au and 7.7 gpt Ag) over 4.45 m etw in hole 23TA-73, including:
    • 3.51 gpt AuEq (3.26 gpt Au and 19.6 gpt Ag) over 1.0 m etw.

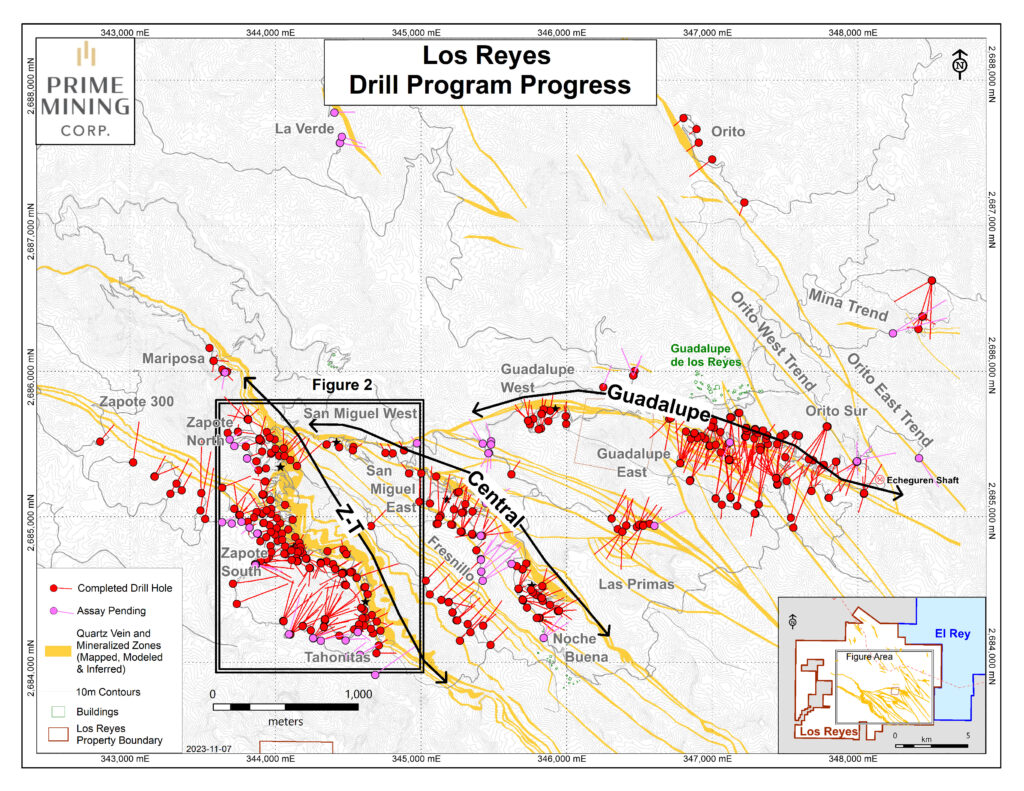

Figure 1 Los Reyes Drill Program Progress_Nov 2023
Figure 1: Expansion drilling update

Drill Hole Highlights1

Hole IDFrom (m)To (m)Interval (m)ETW (m)Au (gpt)Ag (gpt)AuEqAu Cut-offArea
23TA-72319.35320.200.850.851.0774.82.041Tahonitas
23TA-72361.10362.151.051.050.444.60.500.2Tahonitas
23TA-73234.55239.154.604.451.047.71.140.2Tahonitas
including236.60237.651.051.003.2619.63.511.0Tahonitas
23TA-73339.50343.904.404.400.5113.50.680.2Tahonitas
including339.50340.400.900.901.2848.91.911.0Tahonitas
23TA-74417.95425.007.056.950.527.80.620.2Tahonitas
including422.70424.101.401.401.8713.42.041.0Tahonitas
23TA-7513.5015.001.501.450.4916.10.700.2Tahonitas
23TA-75267.70269.101.401.350.762.50.790.2Tahonitas
23TA-75285.85289.253.403.400.424.50.480.2Tahonitas
including285.85286.700.850.851.114.41.171Tahonitas
23TA-75295.00299.004.004.000.4416.20.650.2Tahonitas
23TA-75303.50305.401.901.900.3059.61.070.2Tahonitas
23TA-76263.70266.002.302.150.320.90.330.2Tahonitas
23TA-7791.5094.503.002.700.950.80.960.2Tahonitas
including93.0094.501.501.351.620.61.631Tahonitas
23TA-78242.50244.001.501.500.391.00.400.2Tahonitas
23TA-78281.70284.302.602.550.362.70.390.2Tahonitas
23TA-78292.35295.603.253.201.1144.61.691Tahonitas
23TA-78299.00305.106.106.000.5524.80.870.2Tahonitas
including302.00303.001.001.001.1736.31.641Tahonitas
23TA-79235.90236.800.900.800.625.30.690.2Tahonitas
23TA-79248.15251.403.252.950.3710.50.510.2Tahonitas
23TA-79289.65311.7522.1020.052.1129.32.490.2Tahonitas
including301.55308.456.906.255.7442.96.301Tahonitas
including303.65306.002.352.1511.6746.412.271Tahonitas
23TA-80293.95302.308.357.550.5725.50.900.2Tahonitas
including293.95295.001.050.951.8228.42.191Tahonitas
23TA-80306.00312.006.005.451.0672.62.001Tahonitas
including307.00309.002.001.802.5778.53.591Tahonitas

      1)   See notes below, and the Company’s website for further details, and the full set of drill results.

The nine Tahonitas drill holes summarized in this news release intersected high grades at meaningful widths, continuing to build on the mineralized envelope discussed in the Company’s September 12, 2023 news release. The exploration team is targeting specific areas of these growing high-grade shoots to add Resources within the Z-T Area pit constrained shapes.

Tahonitas continues to demonstrate higher silver grades compared to other zones within the Z-T area. These higher silver grades have the potential to increase the overall AuEq grades and gold-silver ounces in these areas.

High-grade plunging shoots are still open at depth and along strike in multiple areas along the Z-T area and will continue to be a focus of resource expansion drilling for the remainder of the year.

Figure 2 Z-T Drill Program Progress_Nov 2023
Figure 2: Z-T Area drilling update

Figure 3 Z-T Long Section_Nov 2023
Figure 3: Z-T Area long section with drill holes highlighted (A-A’)


Figure 4 Z-T Cross Section TA-4325N 23TA-79
Figure 4: Z-T Area (Tahonitas) cross section B-B’

With the end of the rainy season last month, the exploration team has added an additional two drill rigs. Six drill rigs are now turning at Los Reyes, focusing on:

  1. extending the high-grade Z-T Area shoots that remain open at depth, as well as along strike north and south;
  2. expanding the two other MRE resource areas, including the eastern extensions of the Guadalupe System; and,
  3. exploring the new generative targets, which include Las Primas, Mariposa and a return to Mina 21

Prime has completed over 48,000 m of its planned 60,000 m 2023 drill program and will continue to evaluate its drilling plans using its success-based approach.

Link 1– PDF Figure
Link 2 – PDF Drill Hole Tables

Note 1: Gold equivalent grades are calculated based on an assumed gold price of $US 1700 per ounce and silver price of $22 per ounce, based on the formula AuEq grade (gpt) = Au grade + Ag grade x ($22 / $1,700). Metallurgical recoveries are not considered in the in-situ grade estimate but are estimated to be 93% and 83% for gold and silver, respectively, when processed in a mill, and 72% and 25% respectively when heap-leached.

QA/QC Protocols and Sampling Procedures

Drill core at the Los Reyes project is drilled in predominately HQ size (63.5 millimetre “mm”), reducing to NQ (47.6 mm) when required. Drill core samples are generally 1.50 m long along the core axis with allowance for shorter or longer intervals if required to suit geological constraints. After logging intervals are identified to be sampled, the core is cut and one half is submitted for assay. RC drilling returns rock chips and fines from a 133.35 mm diameter tricone bit. The returns are homogenized and split into 2 halves, with one half submitted for analysis and the other half stored.

Sample QA/QC measures include unmarked certified reference materials, blanks, and field duplicates as well as preparation duplicates are inserted into the sample sequence and make up approximately 8% of the samples submitted to the laboratory for each drill hole.

Samples are picked up from the Project by the laboratory personnel and transported to their facilities in Durango or Hermosillo Mexico, for sample preparation. Sample analysis is carried out by Bureau Veritas and ALS Labs, with fire assay, including over limits fire assay re-analysis, completed at their respective Hermosillo, Mexico laboratories and multi-element analysis completed in North Vancouver, Canada. Drill core sample preparation includes fine crushing of the sample to at least 70% passing less than 2 mm, sample splitting using a riffle splitter, and pulverizing a 250-gram split to at least 85% passing 75 microns.

Gold in diamond drill core is analyzed by fire assay and atomic absorption spectroscopy of a 30 g sample (code FA430 or Au-AA23). Multi-element chemistry is analyzed by 4-Acid digestion of a 0.25-gram sample split (code MA300 or ME-ICP61) with detection by inductively coupled plasma emission spectrometer for a full suite of elements.

Gold assay techniques FA430 and Au-AA23 have an upper detection limit of 10 ppm. Any sample that produces an over-limit gold value via the initial assay technique is sent for gravimetric finish via method FA-530 or Au-GRA21. Silver analyses by MA300 and ME-ICP61 have an upper limit of 200 ppm and 100 ppm, respectively. Samples with over-limit silver values are re-analyzed by fire assay with gravimetric finish FA530 or Au-GRA21.

Both Bureau Veritas and ALS Labs are ISO/IEC accredited assay laboratories.

Qualified Person

Scott Smith, P.Geo., Executive Vice President of Exploration, is a qualified person for the purposes of National Instrument 43-101 and has reviewed and approved the technical content in this news release.

Additional Notes

Metres is represented by “m”; “etw” is Estimated True Width and is based on drill hole geometry or comparisons with other on-section drill holes; “Au” refers to gold, and “Ag” refers to silver; “gpt” is grams per metric tonne; some figures may not sum due to rounding; Composite assay grades presented in summary tables are calculated using a Au grade minimum average of 0.20 gpt or 1.0 gpt as indicated in “Au Cut-off” column of Summary Tables. Maximum internal waste included in any reported composite interval is 3.00 m. The 1.00 gpt Au cut-off is used to define higher-grade “cores” within the lower-grade halo.

About the Los Reyes Gold and Silver Project

Los Reyes is a rapidly evolving high-grade, low sulphidation epithermal gold-silver project located in Sinaloa State, Mexico. Since acquiring Los Reyes in 2019, Prime has spent approximately US$32 million on direct exploration activities and has completed over 158,000 m of drilling. On May 2, 2023, Prime announced an updated multi-million-ounce high-grade open pit constrained resource (see below, and refer to Note 1 and the May 2, 2023 press release for more details).

May 2, 2023 Pit Constrained Resource Statement

May 2, 2023 Pit Constrained Resource Statement

Drilling is on-going and suggests that the three known main deposit areas (Guadalupe, Central and Z-T) are larger than previously reported. Potential also exists for new discoveries where mineralized trends have been identified outside of the currently defined resource areas.

Historic operating results indicate that an estimated 1 million ounces of gold and 60 million ounces of silver were recovered from five separate operations at Los Reyes between 1770 and 1990. Prior to Prime’s acquisition, recent operators of Los Reyes had spent approximately US$20 million on exploration, engineering, and prefeasibility studies.
